- Most new construction homes in a planned Austin-area community take eight to eleven months from signed contract to move-in, and the biggest variable is decision speed, not crew speed.
- NAHB's analysis of the Census Bureau's 2024 Survey of Construction puts homes built for sale at 7.6 months from permit to completion, the fastest of any category, against a 9.1-month national average.
- Your timeline for buying a new construction home is front-loaded. One Austin-area builder gives buyers 21 days to complete design selections after signing.
- Size moves the number as much as the builder does. The same Survey of Construction data puts homes from 1,200 to 3,999 square feet near the national pace and homes over 6,000 square feet at nearly twice that.
- USDA Natural Resources Conservation Service mapping splits the metro: Blackland Prairie clay east of the Balcones Escarpment, shallow soil over Edwards Plateau limestone west of it. Each changes foundation work.
If you have a hard move-in date, get a stage-by-stage schedule in writing before you sign, then compare it against what is already standing in inventory.
A signed contract on a new home comes with a question that follows buyers for months: when do the keys change hands? The answer depends less on how fast a framing crew works than on decisions made before anyone breaks ground.
How long it takes to build a house in Austin is one of the first things relocating buyers search, and the answers contradict each other because they describe different products. The National Association of Home Builders' analysis of the Census Bureau's 2024 Survey of Construction separates them cleanly, and the spread between the fastest and slowest channel is close to double. If you plan to build a home near Austin inside a planned community with a defined floor plan collection, your schedule looks nothing like a custom build on raw acreage.
How Long Does It Take to Build a House in Austin From Contract to Closing?

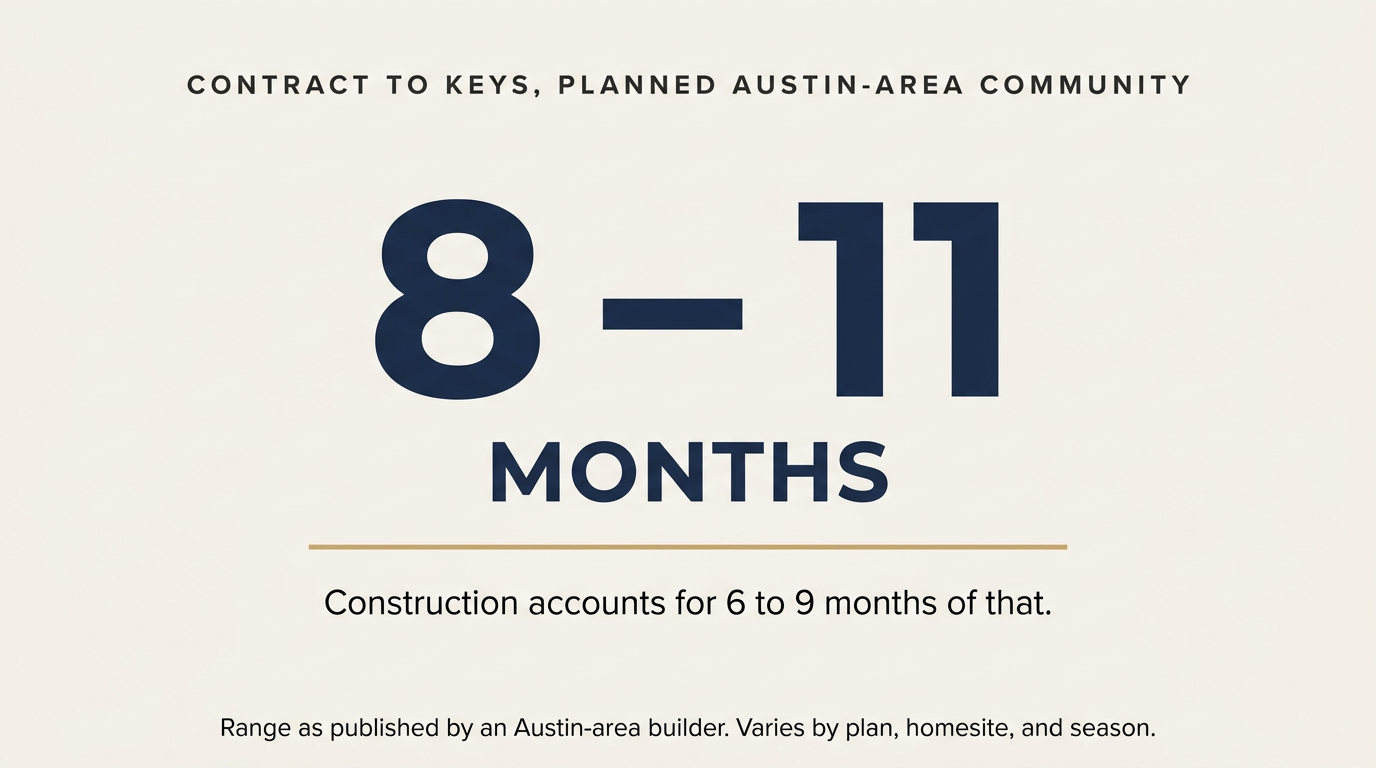

For a to-be-built home in an Austin-area planned community, plan on eight to eleven months from signed Sales Agreement to closing, a range one local builder publishes on its new home buying process page. Construction accounts for six to nine months of that. The rest covers homesite reservation, design selections, final orientation, and closing coordination.
The national benchmark below measures permit to completion rather than contract to closing, but it shows how much the construction channel matters.
| Construction channel | Permit to completion, 2024 |
|---|---|
| Homes built for sale, meaning community and production builders | 7.6 months |
| National average, all single-family homes | 9.1 months |
| Homes built by a hired contractor | About 12 months |
| Homes built by the owner | 15.1 months |
All four figures come from the NAHB analysis linked above.
Why Community Builders Finish Ahead of the Average
The headline number blends every channel together, and owner-built projects pull it upward. Built-for-sale homes run faster because the plan is already engineered, permits follow a repeatable path, and the crews have built that plan before. That is why a new construction timeline Austin buyers get from a community builder tends to be shorter and more reliable than a custom quote.
Square Footage Moves the Number More Than Buyers Expect

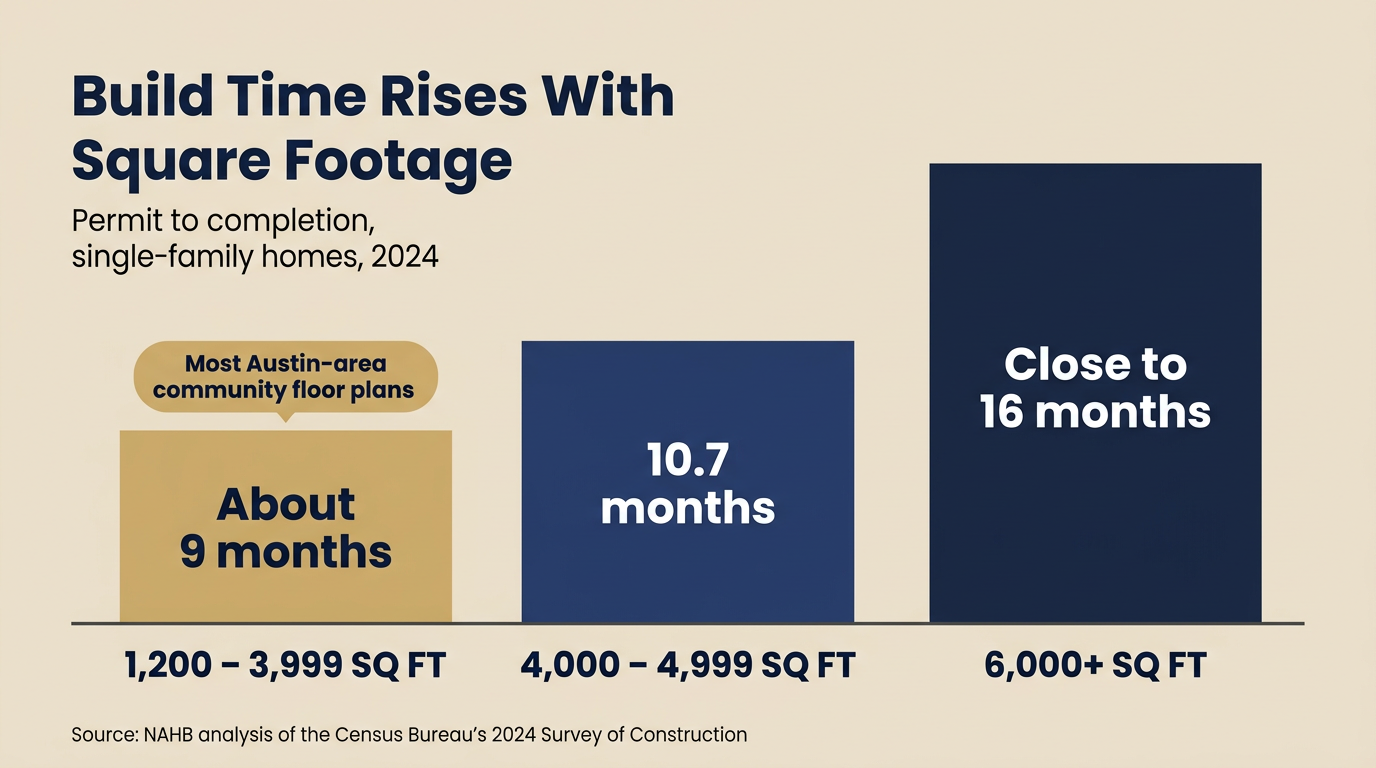

Size is the variable most timeline articles skip. In the same NAHB analysis, homes between 1,200 and 3,999 square feet finished at roughly nine months, while homes from 4,000 to 4,999 square feet took 10.7 months and homes over 6,000 square feet took close to 16 months.
Austin-area community floor plans, including Hill Country plans running roughly 2,350 to 3,700 square feet, sit inside that faster band. The jump that adds real months arrives well above where most planned communities build.

What Happens Before Construction Even Starts?
The stretch between "we found the one" and "they poured the slab" is where most schedules are won or lost. Buyers underestimate it because nothing visible happens on the homesite while a great deal happens on paper.
Reserving a Homesite and Signing the Agreement
Not every floor plan fits every homesite, so plan and lot selection happen together rather than in sequence. Homesite choice affects plan orientation, elevation options, and the lot premium tied to size, view, or position. Signing and placing earnest money holds the homesite and starts construction planning.
The Design Selection Window Is Shorter Than You Think
Selections cover flooring, cabinetry, countertops, tile, plumbing and lighting fixtures, paint, trim, and hardware. Builders set a defined window because those choices drive material orders and lock the schedule. One Austin-area builder gives buyers 21 days from contract execution and treats selections as binding once confirmed.
Missing that window is the most avoidable delay in the home building process Austin buyers navigate. Cabinetry, tile, and fixtures are ordered, manufactured, shipped, and installed in series rather than in parallel, so a late decision costs the delay plus whatever gap opens in the trade schedule.
What Are the Construction Milestones in a New Construction Timeline Austin Buyers Should Track?
Construction follows a fixed sequence, and each stage gates the next. Drywall cannot go up before rough-in inspections pass. Rough-ins cannot start before the frame is dried in. That is why a two-week slip early rarely stays two weeks, and why anyone asking how long it takes to build a house in Austin should read stage durations rather than a headline number.
| Stage | Typical duration | What happens |
|---|---|---|
| Foundation | 3 to 5 weeks | Geotechnical study, plumbing rough-in, steel reinforcement, grade beams, termite barrier, concrete |
| Framing | 2 to 3 weeks | Stick-frame structure raised, roof dried in |
| Mechanical rough-ins | 2 to 3 weeks | HVAC, plumbing top-out, electrical, plus pre-drywall orientation |
| Drywall through final finish | Remaining weeks | Drywall, cabinets, trim, paint, countertops, tile, appliances, landscaping |
| Final orientation to closing | 1 to 2 weeks | Systems walkthrough, punch items resolved, funding, keys |
Stage durations as published by the builder. Ranges vary by plan, homesite, and season.
Foundation Work Carries the Most Local Variation
Foundation is where Central Texas geology asserts itself. The USDA Natural Resources Conservation Service describes the Texas Blackland Prairie as clayey soils with high shrink-swell properties, including the Houston Black series, bordered on the west by the Austin Chalk of the Balcones Escarpment. West of that line, USDA maps the Edwards Plateau as shallow soils over erosion-resistant limestone, some on a cemented caliche layer above bedrock.
Two homes on opposite edges of the metro can therefore be engineered differently. A gated community in Pflugerville sits in the clay belt, where slabs are designed around soil movement. The limestone side is where rock can slow excavation instead. Soil varies lot to lot even inside one subdivision, which is why every build opens with a geotechnical study of that homesite.
Framing Feels Fast, Finish Work Does Not
Framing fools people. A recognizable house appears in about two weeks and buyers conclude the project is nearly done. It is not. Everything after dry-in is a long sequence of short tasks run by different trades in a required order.
A pre-drywall orientation lets buyers see wiring and plumbing before drywall covers them. A well-run home building process Austin buyers can trust treats this as a verification checkpoint rather than a change window. Structural changes here restart material orders and inspections, which is how a nine-month build becomes an eleven-month build.

What Actually Causes Delays When You Build a Home Near Austin?
Delays in Central Texas cluster around five causes. Three of them sit outside a buyer's control, and two do not.
- Rain during dirt work and foundation stages. National Weather Service climate normals for Austin Camp Mabry show May as the wettest month at 5.04 inches and October second at 3.91 inches, against an annual normal of 36.25 inches. Saturated clay has to dry before grading or concrete placement resumes, so the delay outlasts the storm.
- Late or revised design selections. Every day past the deadline pushes material orders, and long-lead items compound the effect.
- Change orders after construction begins. Structural changes mean new engineering, sometimes new permits, and re-sequenced trades.
- Permitting and inspection scheduling. Every jurisdiction in the metro runs its own review process, and a resubmittal cycle adds time no builder controls.
- Trade and material availability. NAHB credits eased supply chain pressure for the recent improvement in build times, but one specialty item on backorder can still hold a certificate of occupancy.
Items two and three are the two you control outright. They are also the only ones where a buying a new construction home timeline can be protected by answering emails quickly.
Here is the arithmetic, using the stage durations above. Sign March 1 and selections are due March 22. Foundation runs 3 to 5 weeks, framing 2 to 3 weeks, rough-ins 2 to 3 weeks, so the structure closes in roughly 7 to 11 weeks after selections. Drywall and finish work fill the balance, then 1 to 2 weeks from orientation to closing. Against the published 8-to-11-month total, a March 1 signature points at closing between early November and early February. Miss the selection deadline and every stage after it shifts, plus the wait for the next open slot in a schedule booked in series.
Should You Build From the Ground Up or Choose a Quick Move-In Home?
This is the fork for anyone with a lease expiration, a school enrollment deadline, or a home already under contract to sell. The right path depends on whether your timeline for buying a new construction home is optimizing for personalization or for certainty.
Building from the ground up gives you elevation, structural options where the plan supports them, and every finish decision. You trade schedule certainty for that control, which is why how long it takes to build a house in Austin has a different answer for every buyer.
Quick move-in homes already under construction invert the equation. Selections are locked, the frame is standing, and much of the weather risk is absorbed. One Austin-area builder reports homes nearing completion often close within 30 to 60 days of a signed agreement. Worth asking at every community: which inventory homes still have finish choices open?
Frequently Asked Questions
Eight to eleven months from signed contract to move-in for a to-be-built home in a planned community. Construction is six to nine months of that. NAHB puts built-for-sale homes nationally at 7.6 months from permit to completion.
Not from the ground up. The shortest realistic path is a home already under construction. Ask what stage it is at, since a framed home and a drywalled home carry very different remaining schedules.
Breaking ground just ahead of the wettest stretch. National Weather Service climate normals put May and October as the two wettest months at Austin Camp Mabry. Interior work is far less weather-sensitive than dirt work, so a build already past foundation is largely insulated.
Late design selections. Cabinetry, tile, and fixtures are ordered, built, shipped, and installed in series, so a decision made a month late can push closing well past a month once trades are re-sequenced.
Measurably. Census Survey of Construction data shows homes from 1,200 to 3,999 square feet finishing at roughly nine months from permit to completion, homes from 4,000 to 4,999 square feet at 10.7 months, and homes over 6,000 square feet at close to 16 months.

Build Your Timeline Around Facts, Not Averages
The most useful answer to how long does it take to build a house in Austin is never the national average. It is the range for your plan on your homesite, from a builder who will put it in writing and name the stage carrying the most risk. Buyers who ask early, finish selections inside the window, and resist mid-build changes close on schedule. Buyers who treat the new construction timeline Austin builders quote as someone else's problem do not. Our first-time buyer guide to new construction covers the financing and inspection work running alongside it.
Keystone Homes has been building in Central Texas since 2011, with gated communities in Pflugerville and Spicewood and structured buyer orientations at every major milestone. Our team will give you a real date range for the plan and homesite you are weighing, plus what is standing in inventory now. Contact the Keystone Homes team for a stage-by-stage schedule on your build.
